Signing a Scope of Work? The Subcontractor Who Never Reads It Decides What You Get

A scope of work written a decade ago assumed one firm did everything. Now it has to survive being handed to people who never met you.

Corporate4 min

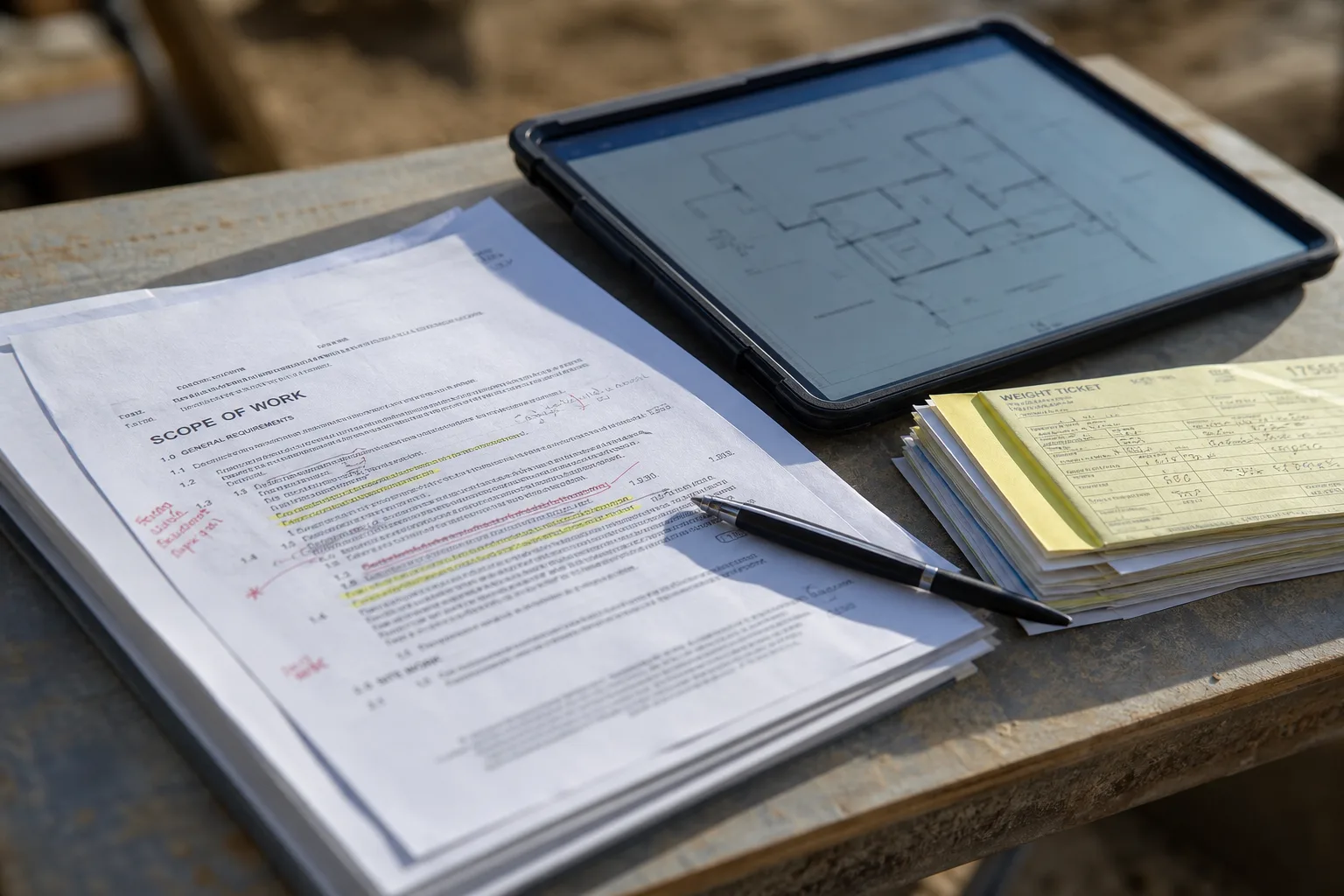

A marked-up printed scope of work document on a job site table, with a pen, a stack of weight tickets, and a tablet showing a floor plan beside it
A marked-up printed scope of work document on a job site table, with a pen, a stack of weight tickets, and a tablet showing a floor plan beside it

The document that governs a professional services engagement is usually drafted by the firm you hired, reviewed by you over a weekend, and then filed. What happens next is the part worth thinking about before you sign. The scope gets broken into pieces, and the pieces go to people who were not in the room: a specialty sub, a testing lab, a hauler, a permit expediter, a manufacturer's certified installer. Each of them works from a fragment. The fragment is what actually gets built, measured, removed, or reported, and it is the fragment you should be writing toward.

What a scope assumed in 2015 and cannot assume now

Ten years ago, a mid-sized engineering, design, or remediation firm could plausibly promise a single deliverable produced mostly in house, and the scope reflected that: a description of the study area, a schedule, a fee, a short exclusions paragraph. The work has since fragmented. Specialized testing, energy modeling, air sealing verification, refrigerant recovery, hazardous material characterization, and disposal documentation are now commonly separate vendors under separate insurance. The scope that worked when one firm owned the whole chain describes an arrangement that no longer exists, and the gaps between the vendors are where the schedule and the budget quietly go.

The practical consequence is that a modern scope has to name interfaces rather than just outcomes. Who supplies the access. Who pulls the permit and who pays the fee if it is denied twice. Whose insurance covers a lab that mishandles a sample. Whose report the utility or the lender will actually accept. A firm that writes these in without being asked is telling you something useful about how many of these engagements it has finished, not started.

The party nobody negotiates with

Clients negotiate hard with the principal and never speak to the subcontractor, who is the person deciding what the finished work looks like on a Tuesday morning in your basement. The sub receives a purchase order, a scope excerpt, a lump sum, and a date. If your excerpt says demolition and disposal and nothing else, the sub prices the fastest legal route: one mixed container, one trip, no separation, no weight tickets. If it says separated disposal with tickets by material stream returned before final payment, the sub prices that instead and does it, because it is now what he is being paid for. Neither version is virtue. One is written down.

This is where the greener option stops being a preference and becomes a procurement detail. Salvage, reuse, and material recovery cost labor on site and save money at the scale, and the trade knows the arithmetic tips differently by region depending on tipping fees and how far the nearest recovery facility sits. Ask the firm to price both ways rather than asking whether they are committed to sustainability. The first question produces two numbers you can compare. The second produces a paragraph.

Documentation is now part of the deliverable

The single biggest change in a decade is that the paper trail carries value it did not carry before. Rebates, incentive programs, insurance underwriting, refinancing, and resale disclosure all now ask for evidence of what was done, by whom, and to what standard. The Environmental Protection Agency oversees how construction and demolition debris and refrigerants are handled, and the handling generates records that somebody has to keep. A scope that ends at physical completion leaves you assembling those records later from vendors who have moved on and whose office manager has changed twice.

So write the records in as deliverables with names and dates. Manifests and weight tickets by stream. Recovery certificates for refrigerant. Product data sheets and serial numbers as installed rather than as specified, because substitutions happen and the substitution is what your rebate application will be judged against. Post-work photographs before anything is closed up. Model files and calculation backup, not only the summary report, since the next consultant will otherwise redo the modeling at your expense. Say who holds each item, in what format, for how long.

Settling the questions that cost money to reopen

Before mobilization, get four things resolved in writing, and resist the temptation to accept a verbal answer on any of them. First, what triggers a change order and what the hourly or unit rate is when one is triggered, because unknown conditions are normal and a blank there means the number is set later by the party who found the condition. Second, whose written approval counts, named by role, so that a well-meaning family member cannot authorize an extra. Third, what constitutes substantial completion and what is held back until closeout documents arrive. Fourth, the disposal and material handling method, priced.

Then send the finished scope, or the relevant excerpt, to the subcontractor before work starts and ask whether anything in it surprises him. This is a five-minute conversation that professionals generally welcome, because a sub who learns about the separated streams on day one prices and staffs for them, while a sub who learns on day three treats them as an ambush. The trade calls this a preconstruction meeting when it is formal. Informally, it is just asking the person doing the work whether the paperwork matches the job.

A scope written this way is longer than the one you were handed, and it takes a couple of extra days at the front. It also makes the engagement legible to everyone touching it, which is what turns a good firm's intentions into a result you can document, finance, and hand to whoever comes next.
